Project Case Study · Cebu, Philippines
A Cebu sports-venue operator set out to build six pickleball courts that could stay open through the rainy season. The result is a 33 m × 40 m × 7 m steel building — 1,320 m² of column-free floor under a single clear span — designed and fabricated in our factory, shipped in three containers, and erected by his own crew in about two months.
This page sets out the dimensions, the wind and water design, exactly what the steel package covered and what his team built, and the factors that move the cost. The story of how the project actually went — including the parts that did not go smoothly — starts further down.
Six courts in this building is not a claim, it is arithmetic. A regulation court is 20 × 44 ft (6.10 × 13.41 m). The recommended playing envelope, which includes run-off at the sides and ends, is 30 × 60 ft — 9.14 × 18.29 m, or 167 m² per court.
Six of those envelopes occupy 1,002 m². The building offers 1,320 m², so 318 m² — just under a quarter of the floor — stays clear for circulation, seating, bag drop and the route to the mezzanine.
| Direction | Courts | Occupied | Left over | Where it goes |
|---|---|---|---|---|
| Across the 33 m span | 3 × 9.14 m | 27.4 m | 5.6 m | 1.8 m between courts and along both side walls |
| Along the 40 m length | 2 × 18.29 m | 36.6 m | 3.4 m | 1.7 m at each end wall |
| Total | 6 courts | 1,002 m² | 318 m² | circulation, seating, mezzanine stair |
Final court positions were fixed in the approved layout drawing. The table shows the dimension logic, not a construction set.
A pickleball court punishes bad buildings. Every interior column is a collision risk; every metre of lost head height eats into lobs and overhead smashes. So the structure was shaped by the sport from the first sketch:
| Building type | Prefabricated steel structure pickleball facility |
| Dimensions | 33 m span × 40 m length × 7 m eave height |
| Floor area | ≈ 1,320 m² |
| Structural system | Portal frame, H-section columns and beams, C/Z-section purlins |
| Steel grade | Q355B main frame (ASTM A572 Gr.50 equivalent) |
| Column spacing | 10 m along the length, zero interior columns across the span |
| Roof & walls | Single-skin metal panels, double-pitched roof |
| Interior | 6 pickleball courts + steel mezzanine (office & reception) |
| Field installation | Client’s own crew, guided remotely by our engineers |
| Shipment | 3 × 40’HQ containers to Cebu |
| Schedule | Erection March 10 – June 17, 2026 (main frame up in about two months); fit-out and court surfacing through July and August; opened late August 2026 |
Cebu sits in the typhoon belt, on a coast, with a rainy season that runs for months. Those three facts shaped the envelope more than any architectural preference.
Wind. In the Philippines, structural wind design follows NSCP 2015, where the basic wind speed comes from the site’s wind zone. On a roof this light the governing case is uplift, not weight — which is why the footing and anchor detail matters as much as the frame itself. Whatever figure a supplier designs to, get it in writing and check it against the zone for your site. It is the number most often left out of a quotation, and the one that decides whether the roof stays on.
Rain. A double pitch over 33 m means water leaves the roof fast and never sits on it. The 7 m eave keeps driving rain out of the playing area, and gutters take it away from the footings rather than dumping it at the base plates.
Salt and heat. Coastal humidity in the Philippines routinely sits above 80%, and unprotected steel does not last in it. Galvanising versus a primer and topcoat system — and at what film thickness — is worth agreeing in writing before fabrication, because it is far cheaper to specify than to repair. A single-skin roof also radiates heat inward: if the venue runs daytime sessions, insulation and ventilation should be priced from the start, not added after the first summer.
Most quotes for a covered court in the Philippines are given as one price per square metre, and that price usually includes foundations, concrete and local labour. A building kit shipped from China does not. Comparing the two numbers without splitting the scope is how buyers end up thinking steel is expensive.
| We supply | You or your local contractor |
|---|---|
| 33 m span portal frames, purlins, bracing, connection plates and bolts | Site preparation, excavation, backfill |
| Roof and wall panels, flashings, gutters and downspouts | Reinforced concrete footings and slab, anchor bolts cast in |
| Structural calculation, shop drawings, anchor bolt setting plan, joint-by-joint bolt schedule | Unloading, crane or forklift, erection labour |
| Packing, container loading, sea freight to Cebu port | Court surfacing and line marking, sports lighting, fencing and netting |
| Remote installation guidance — video calls, annotated photos, time-zone aware | Building permit and inspections (PD 1096), electrical works, comfort rooms, signage |
Seven variables move the price of the steel package on a project like this, roughly in this order:
One thing is worth saying about how the numbers arrive. Ask for the steel package delivered to your port as one figure, and the local civil and fit-out work as another. A single per-square-metre price that mixes both — which is how most turnkey quotes are given — cannot be compared between suppliers, and it is usually how a steel building ends up looking more expensive than it is.
How many pickleball courts fit in a 33 × 40 m building?
Six, using the 30 × 60 ft playing envelope (167 m² each) with 1.8 m between courts and 1.7 m at each end. The 33 m span is what makes six possible without a column in the playing area.
What ceiling height does a pickleball court need?
The rules set no minimum. The ceiling is classed as a permanent object, so a served ball that touches it is a fault — which makes height a playing decision, not a code one. This building uses a 7 m eave, enough for a high lob. Anything above that is paid for in steel.
How much does a covered pickleball court cost in the Philippines?
It depends on span, height, envelope and scope. Ask for two numbers, not one: the steel package delivered to your port, and the local civil and fit-out work. A single per-square-metre figure that mixes both is impossible to compare between suppliers.
Is a steel building suitable for a typhoon zone?
Yes, if it is designed for the wind speed on your site and anchored properly. Uplift is the governing case on a light roof, so the footing and anchor detail matters as much as the frame. Ask for the design wind speed in writing.
Can our own crew erect it, without an installation team from China?
This client did exactly that — main frame up in about two months, guided remotely. It works when the drawing package is written for the people holding it, the unloading plan is agreed before shipment, and someone on site can read a setting-out plan. Budget for a crane or a large forklift at unloading.
How long does it take from order to a weathertight building?
Production begins once the drawing set is approved, and the three containers are booked as one shipment so the kit arrives complete rather than in stages. On this project the crew set the first column on March 10, 2026 and the roof and wall sheets were on by June 17.
Can the building be used for other sports later?
That is the point of paying for the clear span. With no interior columns, the floor can be relined for futsal, badminton, volleyball or events without touching the structure.
The sport reached the Philippines in 2016 — fittingly, with the country’s first clinic held in Cebu. Since then it has grown from a niche expat pastime into a national movement: by 2025 the Philippine Pickleball Federation counted more than 200 registered clubs and 13,000 registered members, and local press reported over 100,000 players booking court time through a single booking app.
Supply has not kept up. Across Cebu, most play still happens on converted basketball courts, backyard slabs and borrowed multipurpose spaces. Coaches quoted in local media describe the growth as “exponential” — and the shortage of dedicated venues as the sport’s biggest bottleneck. For an operator, that gap is the opportunity: players will pay for proper courts and a roof that keeps games running through the rainy season.
Our client runs a sports venue business in Cebu. He did the math on land, courts and throughput, and concluded that a purpose-built covered facility — six courts, playable in any weather — was worth the investment. What he had never done was buy a steel building, let alone one shipped from China.
The first message came through Facebook — still the main channel through which Philippine buyers find suppliers. What followed was not really about price. It was about trust: Is the factory real? Will the steel match the drawings? What happens after I pay?
Those are fair questions for a first-time importer, so instead of arguing on chat, we did something simpler. Sophia Liu, our export consultant for Southeast Asia, connected the client with Darren — a long-standing customer in the region — so he could hear it from someone with no stake in the sale. Then the client visited China, walked the factory floor, watched panels being produced, and checked the welding and shot-blasting lines himself.
He placed the order after the visit. Not because the factory looked impressive in photos, but because he had stood in it.

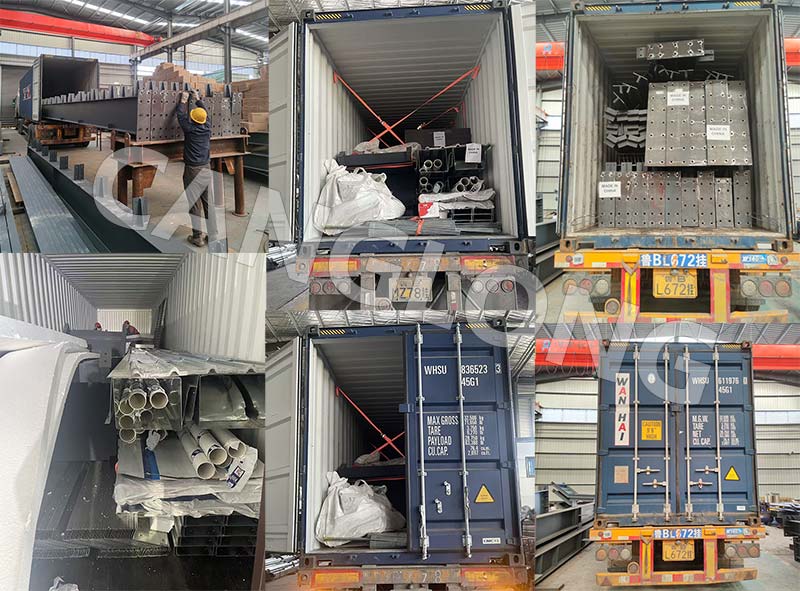

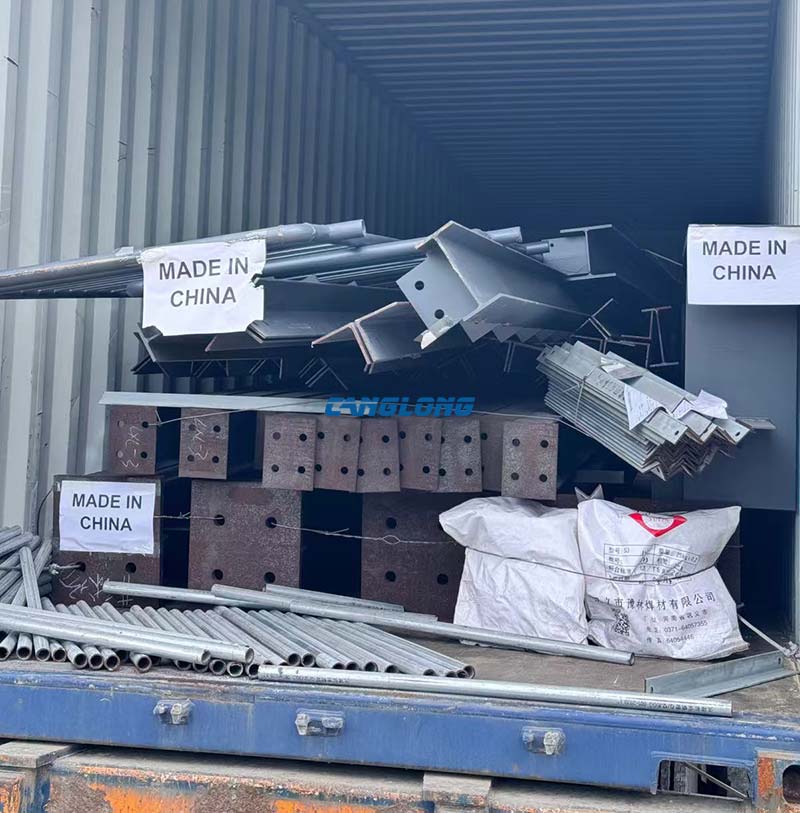

The complete kit — primary frames, purlins, roof and wall panels, mezzanine steel — was fabricated, inspected and loaded into three 40’HQ containers. On day one at site, the crew damaged one crate while unloading. No steel was lost and nothing had to be re-made, but the moment made a point no brochure can: a kit arrives as several tonnes of long, heavy, precisely machined components, and getting it off a container is a skill of its own.
Midway through the foundation stage, the crew asked for two drawings at a level of detail the original set did not carry. Neither was a structural error — both were cases where a drawing that is clear to an experienced crew leaves too much open for a first-time one. The crew raised them rather than guess, which was the right call, and we reissued both before the next pour.
Foundation — a full anchor bolt setting plan. The original drawing gave the bolt layout but not the level of detail needed to set and check every bolt before concrete goes in. An anchor bolt out of position means breaking out cured concrete and a column base that will never sit plumb. We reissued it as a complete setting plan — every bolt located, sized and specified — so the layout could be verified against the base plates before the pour. The foundation then went in without another question.
Connections — a joint-by-joint bolt schedule. A portal frame does not use one bolt throughout: diameter, grade and length change from joint to joint, and a general arrangement drawing does not tell a first-time erector which one belongs where. We issued a dedicated bolt installation drawing — every connection numbered, with size, grade, length and quantity listed against it — so each bolt could be identified before it came out of the crate.
What separates a drawing set that keeps a site moving from one that stops it is rarely the engineering. It is whether the drawings were produced for the people who will actually hold them.
We did not send an installation crew to Cebu. The client chose to erect the building with his own team, supported by our engineers remotely — every question, from column plumb tolerance to purlin spacing to panel screw sequence, answered with annotated drawings, photos and video calls worked around the time difference.

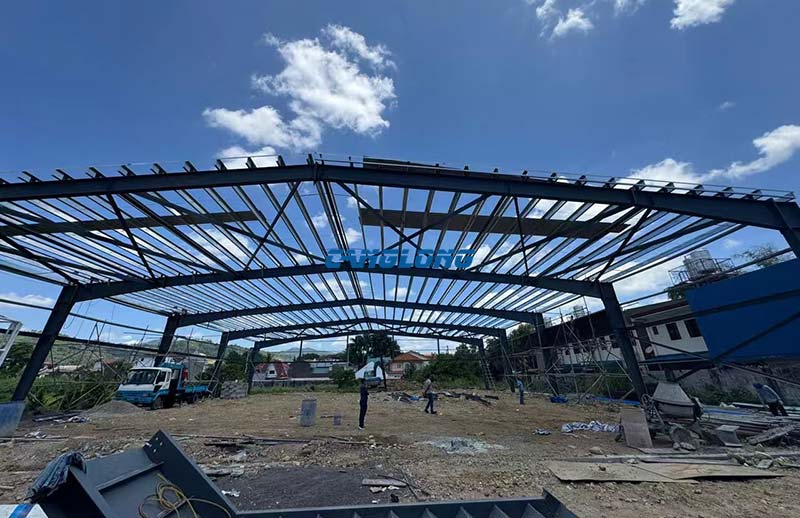

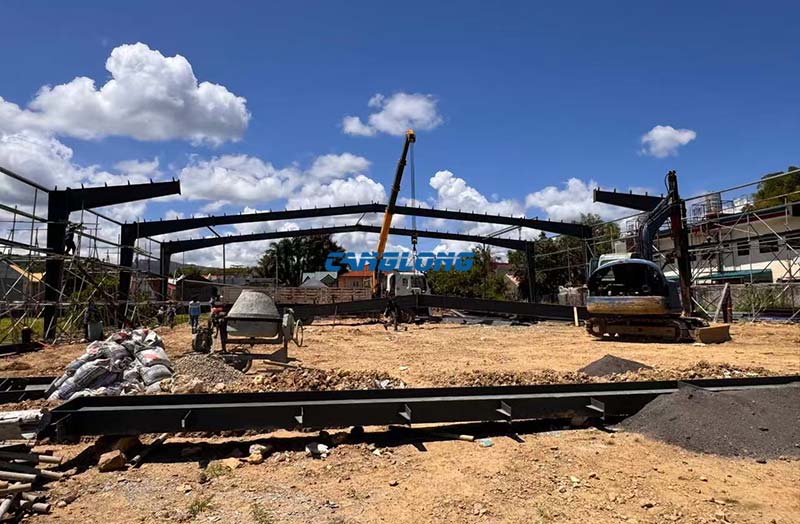

The crew set the first columns on March 10, 2026. About two months later the main frame was standing; by June 17 the roof and wall sheets were on, the building was weathertight and the courts were taking shape inside. Fit-out — surfacing, lighting, mezzanine offices and reception — ran through July and August, and the venue opened at the end of August 2026.

In our post-completion follow-up, the client rated the project 8 out of 10. We publish that number deliberately: a file of ten-out-of-ten scores would be easy to produce and impossible to believe. An 8, from a first-time buyer who saw exactly how we handle a detail his crew could not build from, tells you the problems above were resolved — not just acknowledged.
For us the project settled a broader question: a 33-metre clear span, a two-month frame erection and a crew of first-time erectors working from a video call turned an empty lot in Cebu into one of the few dedicated six-court pickleball venues in the central Philippines.
If you are weighing up a covered pickleball or sports facility — in the Philippines, Southeast Asia or Oceania — talk to the person who ran this one end to end: the factory visit, the three containers and every video call with the erection crew. Send your site size, court count and location, and you will get a proposal that separates the steel package from the local work, so the two numbers can actually be compared.
Sophia handled the Cebu pickleball project from first message to final panel screw. Send her your site size, court count and location for a proposal with the steel package and the local scope priced separately.
