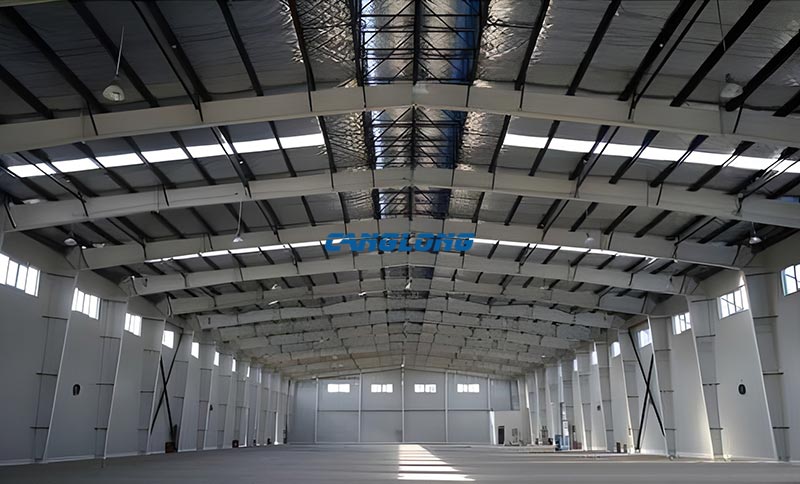

A single story factory building keeps the entire production process on one ground-level floor: raw material intake, machining, assembly, packing, and dispatch all happen under the same roof. Nothing moves between levels, so forklifts replace elevators, heavy machines sit on reinforced ground slabs instead of elevated floor decks, and every roof-mounted service—cranes, ventilators, daylight panels, later even rooftop solar—stays within reach for inspection and maintenance.
Canglong fabricates single-story steel factory buildings as welded H-section portal frames, with member sizes calculated against the wind, snow, and seismic data of each project site rather than copied from a catalog. Frames are prefabricated, numbered, and bolted on site, which keeps a typical fabrication-to-shipment cycle at around 30–45 days depending on tonnage.

Buyers rarely choose a single-story factory because it is cheap. They choose it because of how a factory floor actually works:
The trade-off is land. A single-level building uses roughly twice the footprint of a two-storey one for the same floor area. Where the site is small or land is expensive, that calculation can flip—see the comparison below.
The table below lists common configurations. Final member sizes always follow the structural calculation for your site.
| Item | Typical Range |
|---|---|
| Main frame | Welded H-section columns and rafters, Q235B / Q355B steel |
| Clear span | 15 m to 36 m, column-free; larger spans engineered case by case |
| Bay spacing | 6–9 m |
| Eave height | 6–12 m |
| Roof & wall | Profiled steel sheet, or EPS / rock wool / glass wool sandwich panel |
| Steel coating | Al-zinc coated sheet (AZ150), galvanized purlins; painted or hot-dip galvanized frame |
| Crane provision | 5–50 t overhead crane runway beams, designed in from the start |
| Connections | High-strength bolting on site; all members numbered for assembly |
| Design basis | Project-specific wind, snow, and seismic loads per local codes (IBC, EN, GB and others) |
| Service life | 25+ years with standard maintenance |

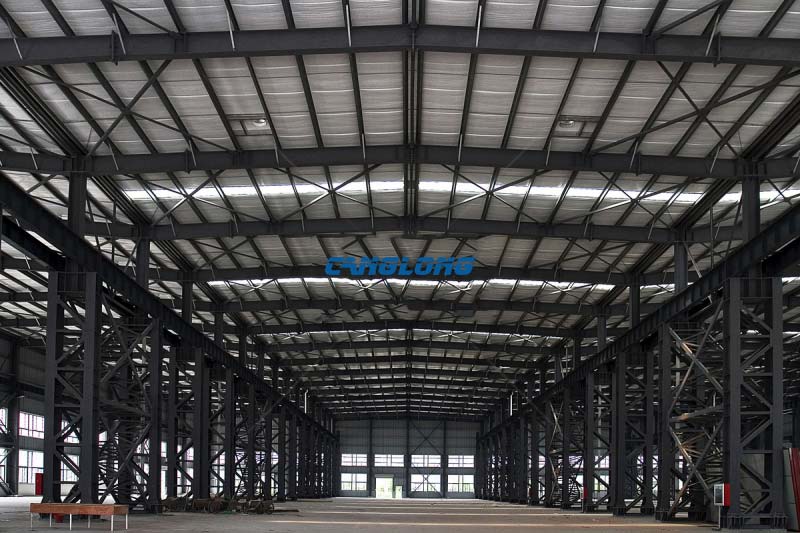

The primary system is a portal frame: rigid connections between columns and rafters carry the loads, while bracing between frames stabilizes the building along its length. Secondary C/Z purlins and girts span between the main frames and support the cladding.
The envelope is specified separately from the frame, which is what lets the same structure serve a ventilated assembly hall in a tropical port city and a heated workshop at −30°C. Doors, windows, gutters, skylights, and ventilation openings are coordinated with the structural drawings before fabrication, not bolted on afterwards.

For projects in Southeast Asia and Oceania, the design questions are wind uplift during typhoon season and condensation on the underside of the roof. We address both with calculated purlin and fastener spacing for the site wind load, insulated sandwich panels to cut solar heat gain and air-conditioning cost, and ventilation openings sized for the actual internal heat load rather than a fixed ratio.
For buyers in Mongolia, Central Asia, and similar climates, snow load distribution and thermal performance drive the design: rafter depths and bracing follow the ground and drift snow loads, rock wool panel thickness is selected against the heating requirement, and thermal bridges at purlins and door frames are detailed out to control condensation inside the workshop.
Both are steel factory buildings; the difference is what the production process demands and what the site allows.
| Factor | Single-Storey | Multi-Storey |
|---|---|---|
| Material flow | Straight-line, forklift-based | Vertical, depends on lifts |
| Floor load | Limited only by the ground and frame design | Fixed per-square-meter slab capacity |
| Land use | Large footprint | Suits compact or high-value sites |
| Structure cost per m² | Lower | Higher (slabs, lifts, fire zoning) |
| Later expansion | Add bays at the gable end | Fixed once built |
| Typical fit | Heavy manufacturing, assembly, processing | Light industry, urban sites, warehousing on scarce land |
If your project needs several usable levels on a tight site, our multi-storey factory building page covers that system. For a proven starting configuration with common span and bay options, see the standard factory building.
A single-story factory is priced accurately when the inquiry includes the details that change the structure:
Send these through our contact page and the engineering team will come back with a configuration proposal and quotation rather than a generic price per square meter.

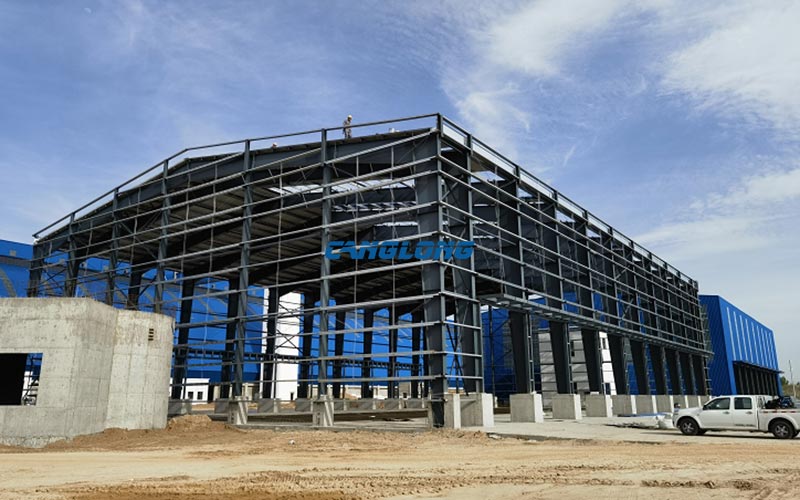

All members are cut, welded, and drilled on automated lines, inspected, then bundled and loaded into 40HQ containers or shipped in bulk depending on tonnage. Every part arrives numbered to match the assembly drawings, and our installation teams—who have worked in more than 30 countries—can guide your crew on site or handle erection directly. From deposit to ex-factory, plan on 30–45 days for a typical single-story factory order.

It depends mainly on span, eave height, wind or snow load, crane provisions, and the enclosure system—two buildings of identical size can differ by 30% or more in steel weight. We quote per project after the configuration is confirmed, which is why the checklist above matters.
Only within limits. Crane columns and runway beams must be designed into the frame from the start; retrofitting a heavier crane than the frame was designed for usually means reinforcing the columns. If lifting capacity might grow later, tell us at the design stage and we will pre-provision it.
Standard portal frames cover up to 36 m economically. Beyond that, the economics shift toward trusses or other systems, which we engineer case by case.
Members are bundled, containerized, and bolted together on site with high-strength bolts—no site welding for the main structure. A trained local crew with one crane can erect a mid-size factory in weeks, following our numbered drawings.
Yes, along the gable end. If extension is planned, we detail the end wall and future connection points accordingly, so the new bays bolt onto the existing frame without cutting or re-welding.
Share your building dimensions, location, and production requirements. Our engineering team will review the loads, recommend a configuration, and quote from there.
